Sprint Planning & Backlog Refiner — Definition of Ready + Capacity Gate
by Vivek K
Refines each backlog story against a Definition of Ready, splits oversized work, maps blockers, and issues a COMMIT / COMMIT-WITH-RISK / OVER-COMMITTED verdict against real sprint capacity.
Secure checkout via Stripe
See it in action
You say
Product: Inkline (creative proofing for agencies) Sprint 41 · 2 weeks · capacity 13 pts (historical ~16; Jin OOO 3 days) Sprint goal: clients comment on proofs; agencies compare versions
Backlog: S1 Pin comments on PDF (5) — AC present S2 Side-by-side version compare (13) — no AC S3 Magic-link client access (5) — blocked: Auth tenant not provisioned S4 “Improve upload performance” — unsized, vague S5 Resolve/reopen comment threads (3) — AC present S6 Require client approval before Final (5) — AC present, Figma missing S7 Download PDF + comments summary (8) — rough idea S8 Filter comments open/resolved/mine (2) — AC present
Ask: refine DoR, splits, dependencies, capacity-aware commitment. Do not write to Jira.
Your agent does

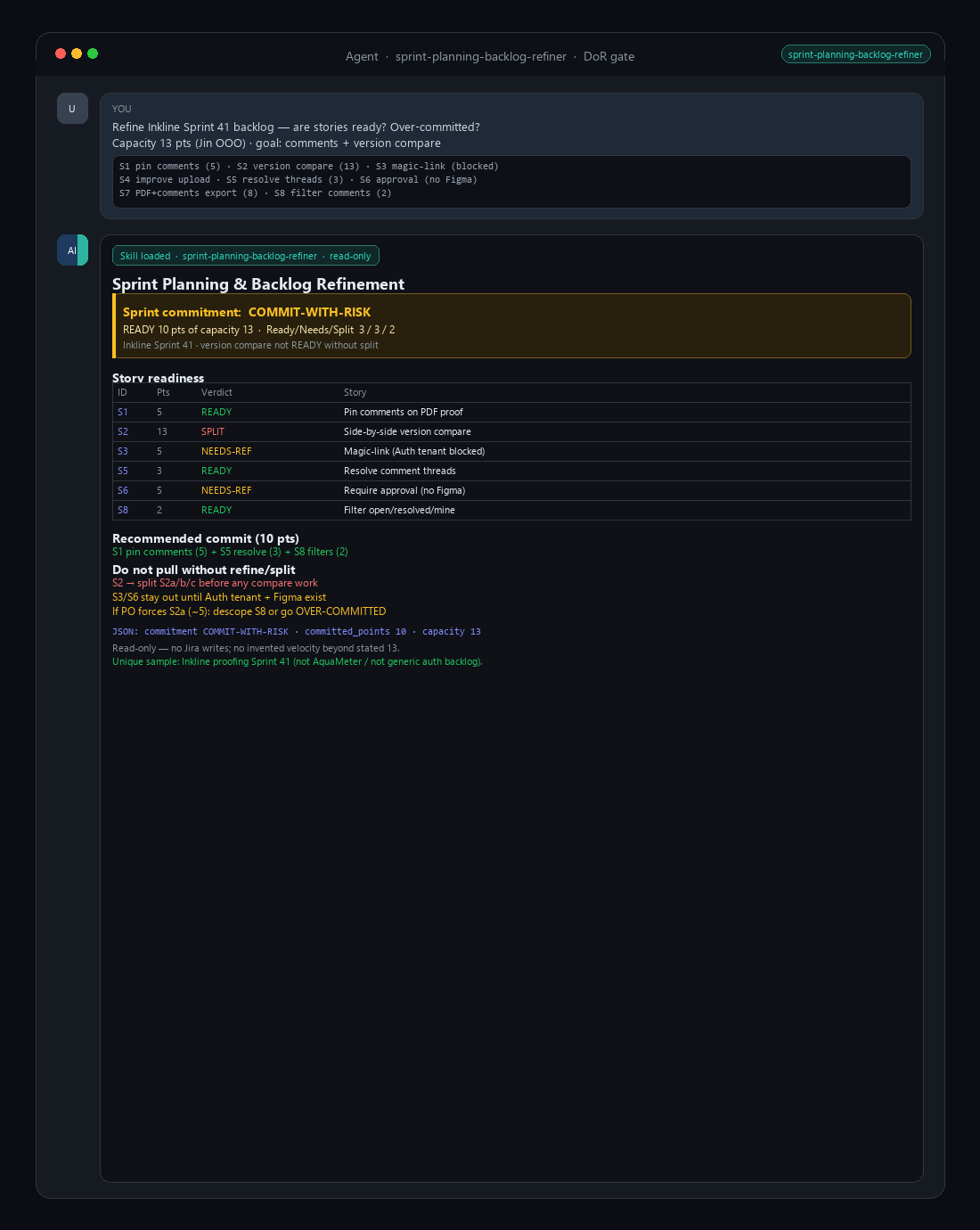

Sprint Planning & Backlog Refinement
1. Sprint Summary
| Field | Value | |---|---| | Sprint | Sprint 41 (2 weeks) | | Capacity | 13 points (Jin OOO adjustment; historical full-staff ~16) | | Stories refined | 8 | | Ready / Needs-refinement / Split | 3 / 3 / 2 | | Committed points | 10 of 13 (READY only) | | Sprint commitment | COMMIT-WITH-RISK |
Why COMMIT-WITH-RISK: 10 ≤ 13 (not over capacity), but version-compare (sprint goal) is not READY without a split, S6 lacks Figma, and reduced capacity leaves little bug buffer.
2. Story Readiness
| ID | Pts | Readiness | Why | |---|---:|---|---| | S1 Pin comments | 5 | READY | Clear value + testable AC | | S2 Version compare | 13 | SPLIT | Too large vs capacity / small-enough rule | | S3 Magic-link access | 5 | NEEDS-REFINEMENT | Auth tenant blocker | | S4 Upload performance | — | NEEDS-REFINEMENT | Vague, UNSIZED, no metric | | S5 Resolve threads | 3 | READY | Clear + testable AC | | S6 Require approval | 5 | NEEDS-REFINEMENT | Missing Figma asset | | S7 PDF + comments export | 8 | SPLIT | Multi-concern; split recommended | | S8 Filter comments | 2 | READY | Clear + testable AC |
3. Refined READY stories (commit these)
S1 (5) — pin comments: pin at coordinates; author/time/page visible; pins persist S5 (3) — resolve/reopen threads with Open filter behavior S8 (2) — filters for Open / Resolved / Mine READY total = 10 points
4. Needs refinement (do not commit yet)
| ID | Fix | |---|---| | S3 | Provision Auth tenant + AC for expiry | | S4 | Rewrite with measurable p95 upload target + size | | S6 | Attach Figma approval modal |
5. Split suggestions
S2 (13) → S2a side-by-side shell · S2b synced navigation · S2c highlights S7 (8) → S7a download PDF · S7b summary page · S7c merged export
6. Dependency map
- S3 blocked by Auth tenant
inkline-preview - S6 blocked by missing Figma
- S7b/c richer after S1 pins land (soft)
7. Commitment analysis
| | | |---|---| | Capacity | 13 | | READY commit | S1+S5+S8 = 10 | | Headroom | 3 | | Verdict | COMMIT-WITH-RISK |
Do not pull: whole S2/S7, S3, S4, S6. If PO forces compare: refine S2a only, then descope S8 (or accept OVER-COMMITTED if 10+5 > 13).
8. Sprint Backlog JSON
Machine-readable stories[], readiness, splits, dependency_map, descope_recommendations, committed_points: 10, commitment: "COMMIT-WITH-RISK", assumptions labeled (capacity 13 not invented; split points need team confirm).
What you get
About this skill
The problem
- Sprint planning fails when vague stories, missing acceptance criteria, and silent blockers get committed as if they were ready.
- Oversized items (13+ points) hide in the sprint and blow the goal.
- Teams need a capacity-honest commit — not a wish list.
What it does
- Scores each story READY, NEEDS-REFINEMENT, or SPLIT against a Definition of Ready.
- Validates or proposes testable acceptance criteria (Given/When/Then where useful).
- Suggests vertical-slice splits for oversized work.
- Maps dependencies (“blocked by”).
- Commits only READY work and returns COMMIT, COMMIT-WITH-RISK, or OVER-COMMITTED with descope recommendations.
Frameworks & tools
- Works with any backlog format (Jira export, Linear list, markdown stories).
- Story-point or capacity-based planning; stack-agnostic product work.
- Outputs markdown + JSON you paste into the tracker — no SaaS integration required.
Why this beats prompting it yourself
- Explicit DoR gate so “Improve performance” cannot slip in as READY.
- Only READY points count toward commitment math.
- Deterministic commit rules (over capacity → OVER-COMMITTED).
- Named descope order when overloaded.
- Anti-fabrication: UNSIZED stays null; assumptions labeled.
How to install
Drop the file into your AI Agent. Works with Claude, Cursor, ChatGPT, and 20+ more.
Reviews
No reviews yet
Be one of the first to try it. Every listed skill passes our trust checks below.
Security scanned
Passed our 8-point scan before listing
Fresh listing
Recently published to Agensi
30-day refund
Not a fit? Get your money back
Trust & safety
Security scanned
Verified clean today
- 30-day refund guarantee
- One-time purchase, yours forever
- Secure checkout via Stripe
Creator
15 skills on Agensi
Frequently Asked Questions
Popular in Business & Operations
business-planner
Transform business ideas into rigorous, scenario-based execution plans with explicit assumptions and KPIs.

Business Strategist
A framework-driven consultant for business diagnosis, market mapping, and pricing strategy.
Project Management Decision Engine
Project management engine with methodology comparison (Scrum/Kanban/Waterfall/SAFe/Hybrid), project charter template, agile practices, risk management, retrospective SOP.

pre-mortem
Run disciplined pre-mortems that replace generic risk lists with project-specific failure modes and binding decisions.
